ISRO CS Scientist/Engineer Role: Projects, Testing and Career Growth

See how core CS knowledge can support a project lifecycle through a fictional telemetry monitor, from requirement and design to testing, review and maintenance.

KnowledgeGate Team

Exam prep & CS education

Updated 30 Oct 20265 min read93 views
ISRO CS Scientist/Engineer Role: Projects, Testing and Career Growth

An exam syllabus tells you what to study, but it does not show how Computer Science supports engineering work after selection. Computer Science supports that work through software development, testing, documentation, reviews and teamwork. A telemetry-monitor example turns one requirement into a design, measurable test evidence and a review-ready package, showing how subject knowledge becomes engineering work.

1. ISRO CS Scientist/Engineer work: think project lifecycle, not only coding

ISRO CS engineering loop from requirement clarification through testing, evidence, review and maintenance.

ISRO's official procedure page says Department of Space activities are largely project oriented. Its examples of decisions include technology choices, system or subsystem specifications, interfaces, test setups and testing methodology.

The telemetry monitor illustrates one engineering workflow. Actual duties, review ownership and progression depend on the centre, unit, project, assignment and current ISRO rules.

The engineering loop is: clarify requirement, define interfaces, design, implement, unit and integration test, document evidence, review, then maintain. Coding is one part of that loop. For example, a sensor team supplies values and timing, a protocol team transports them, a CS engineer validates and stores them, and systems, quality and operations teams review the evidence. Use GATE, PSU, Engineering & Technical Exams for recruitment context. Selection-stage preparation is separate from the engineering lifecycle and evidence shown by this project. For the written-test versus interview response modes, read ISRO CS Written vs Interview: What Each Stage Demands. That post owns stage-specific preparation; this one owns the project lifecycle, test evidence and review-ready engineering decisions.

2. ISRO CS project example: turn a telemetry need into a testable design

Requirement REQ-TLM-03 says: accept 25 telemetry values per second from each of 8 subsystems, store each in 40 bytes, alert within 1.0 second after the third consecutive temperature sample above 75 degrees C, and log missing sequence numbers and stale timestamps.

The load calculation is direct:

  • 8 x 25 = 200 samples/s

  • 200 x 40 = 8,000 bytes/s

  • 10 minutes = 600 s

  • 200 x 600 = 120,000 samples

  • 8,000 x 600 = 4,800,000 bytes = 4.8 MB in decimal units

The eight streams are aggregated only for throughput, storage and buffer calculations. Each record carries subsystem_id and parameter_id; separate last-sequence, last-timestamp and threshold-counter state is kept for every pair. Interleaved records therefore cannot create false loss, stale-time or threshold results.

Build an ingest adapter, sequence and timestamp validator, 2,000-sample ring buffer, threshold rule engine, audit store and alert interface. Together, these components create a pipeline whose behaviour can be checked against the original requirement. The review package should contain a one-page requirement table, interface definition, component diagram, test plan and test report.

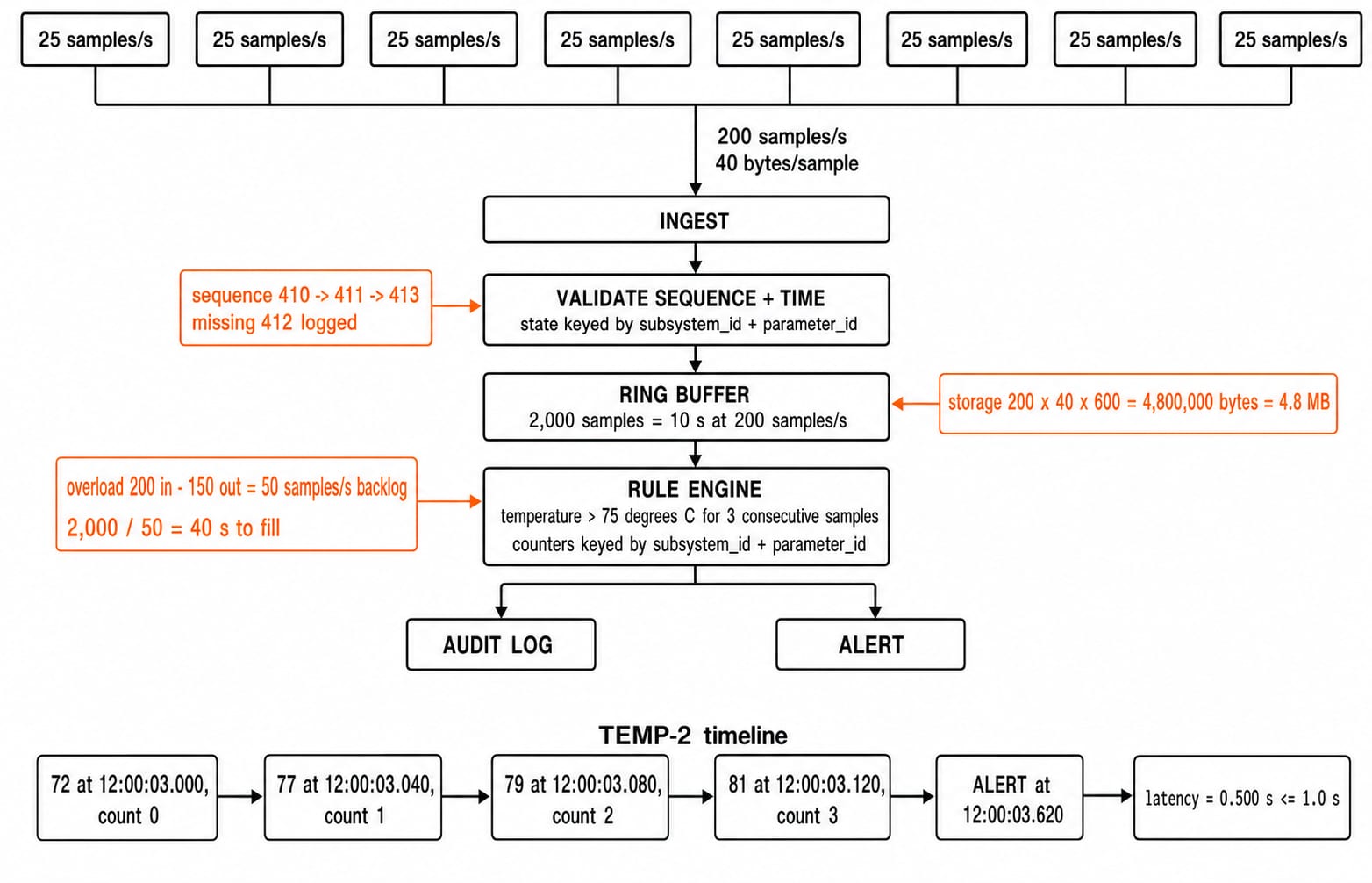

Telemetry pipeline diagram showing eight input streams, validation, a ring buffer, threshold alerts, sequence loss, storage, overload and the TEMP-2 timing trace.

3. Software testing in the example: prove load, thresholds and failure paths

Plan expected results before running the software. Do not replace evidence with “tested successfully”.

For each (subsystem_id, parameter_id) stream, source timestamps must be nondecreasing: an incoming timestamp earlier than that stream's last accepted timestamp is stale and must be flagged; an equal timestamp is allowed.

Test

Input

Expected result

Nominal load

200 samples/s for 600 s

120,000 accepted records; 4.8 MB raw payload

Threshold and alert latency

TEMP-2: 72 at 12:00:03.000, 77 at 12:00:03.040, 79 at 12:00:03.080, 81 at 12:00:03.120; alert recorded at 12:00:03.620

No alert at 72; 81 is the third consecutive value above 75; alert latency must be no more than 1.0 s

Counter reset

76, 74, 78

No alert because 74 resets the counter

Sequence loss

IDs 410, 411, 413

Missing ID 412 logged

Stale time

For one (subsystem_id, parameter_id) stream, 12:00:04 after accepted 12:00:05

Stale-record flag because 12:00:04 is earlier than that stream's last accepted timestamp

The third qualifying sample arrived at 12:00:03.120, and the alert was recorded at 12:00:03.620. The measured delay is 03.620 - 03.120 = 0.500 s; because 0.500 s <= 1.0 s, REQ-TLM-03 passes the alert-latency test.

Use unit tests for rule logic, integration tests across ingest and storage, and a system test for sustained load. A useful report records the build ID, environment, input, expected result and observed result.

4. Technical documentation and design reviews: make every claim traceable

One traceability row can connect REQ-TLM-03 -> DES-RULE-02 -> TC-THR-02. The requirement is three consecutive readings above 75 degrees C. The design uses a counter that resets on any reading at or below 75. The test sends 72, 77, 79, 81 and expects the alert after 81.

The official procedure page says systematic reviews are organised at project milestones, including Preliminary Design Review, Detailed Design Review, Critical Design Review and Pre-Shipment Review. These reviews assess progress, resolve interfaces and check compliance with project objectives.

In a review, an engineer defends the requirement interpretation, interface assumptions, buffer size, overflow policy, test coverage, failures and evidence. For interview rehearsal and whiteboard project defence, read ISRO CS Interview: Defend Projects on the Whiteboard. That post owns explaining a project under follow-up questions; this one owns the engineering lifecycle, test evidence and review-package traceability.

5. ISRO CS syllabus-to-role map: turn core subjects into engineering decisions

Core areas map to concrete decisions in the telemetry example:

Course-prepared area

Decision in the example

Exact evidence

Data Structures and Algorithms

Ring buffer sizing

2,000 / 200 = 10 s capacity

Operating Systems

Producer-consumer backlog

200/s - 150/s = 50/s; 2,000 / 50 = 40 s to fill

Computer Networks

Ordering and loss

IDs 410, 411, 413 reveal missing 412

DBMS

Auditable event record

{subsystem: S3, parameter: TEMP-2, sample_timestamp: 12:00:03.120, value: 81, unit: C, alert_timestamp: 12:00:03.620, status: ALERT}

Software Engineering

Traceability

REQ-TLM-03 -> DES-RULE-02 -> TC-THR-02

Basic AI

Possible anomaly scoring

The deterministic threshold remains the approved example requirement

If you already study GATE topics, read ISRO CS vs GATE CS: Overlap, Gaps, 14-Day Revision Plan for the overlap-and-gap comparison and bridge plan. That post owns cross-exam planning; this map owns how core subjects drive decisions in the telemetry example.

6. Career growth: increase the scope and quality of engineering decisions

Think of growth as a capability ladder. First, deliver a reviewed component. Then own its requirement, interfaces and tests. Next, coordinate subsystem integration and close review actions. Later, mentor others and make broader reliability, risk and maintainability trade-offs.

Visible evidence includes clearer specifications, fewer ambiguous interfaces, reproducible test results, documented defect closure and calm review explanations. It also appears in sound decisions under technical constraints. Build technical depth, verification discipline, communication and systems thinking.

7. The short version: build one role-aware project and prepare the core

The useful role model is requirement, design, code, test, evidence, review and maintenance. This loop prepares you for project work.

Try a focused 90-minute project sprint. Spend 15 minutes writing REQ-TLM-03 and its interface, 25 minutes sketching ingest, validation, the 2,000-slot buffer and threshold rule, 20 minutes tracing the five tests, 15 minutes writing the traceability row, and 15 minutes explaining the 10-second buffer and 40-second overload result aloud.

For structured core-subject preparation, use the ISRO Scientist/Engineer SC (CS) Course. If you only need role-aware practice, complete the standalone project sprint first.
